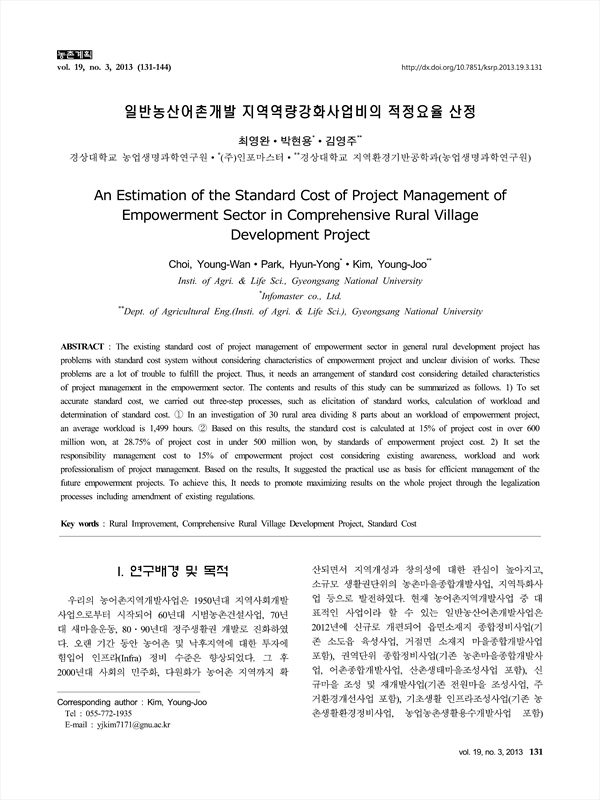

The existing standard cost of project management of empowerment sector in general rural development project has problems with standard cost system without considering characteristics of empowerment project and unclear division of works. These problems are a lot of trouble to fulfill the project. Thus, it needs an arrangement of standard cost considering detailed characteristics of project management in the empowerment sector. The contents and results of this study can be summarized as follows. 1) To set accurate standard cost, we carried out three-step processes, such as elicitation of standard works, calculation of workload and determination of standard cost. (1) In an investigation of 30 rural area dividing 8 parts about an workload of empowerment project, an average workload is 1,499 hours. (2) Based on this results, the standard cost is calculated at 15% of project cost in over 600 million won, at 28.75% of project cost in under 500 million won, by standards of empowerment project cost. 2) It set the responsibility management cost to 15% of empowerment project cost considering existing awareness, workload and work professionalism of project management. Based on the results, It suggested the practical use as basis for efficient management of the future empowerment projects. To achieve this, It needs to promote maximizing results on the whole project through the legalization processes including amendment of existing regulations.
