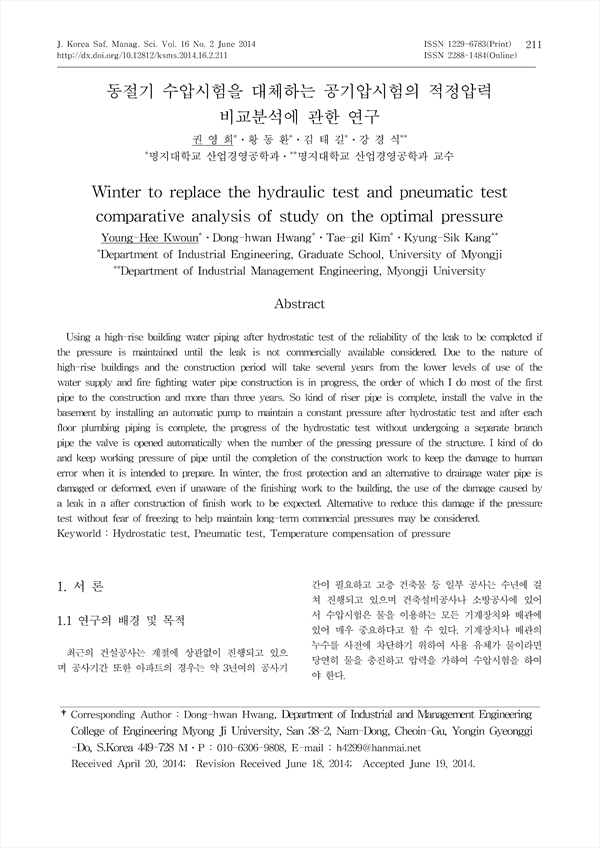

Using a high-rise building water piping after hydrostatic test of the reliability of the leak to be completed if the pressure is maintained until the leak is not commercially available considered. Due to the nature of high-rise buildings and the construction period will take several years from the lower levels of use of the water supply and fire fighting water pipe construction is in progress, the order of which I do most of the first pipe to the construction and more than three years. So kind of riser pipe is complete, install the valve in the basement by installing an automatic pump to maintain a constant pressure after hydrostatic test and after each floor plumbing piping is complete, the progress of the hydrostatic test without undergoing a separate branch pipe the valve is opened automatically when the number of the pressing pressure of the structure. I kind of do and keep working pressure of pipe until the completion of the construction work to keep the damage to human error when it is intended to prepare. In winter, the frost protection and an alternative to drainage water pipe is damaged or deformed, even if unaware of the finishing work to the building, the use of the damage caused by a leak in a after construction of finish work to be expected. Alternative to reduce this damage if the pressure test without fear of freezing to help maintain long-term commercial pressures may be considered.
