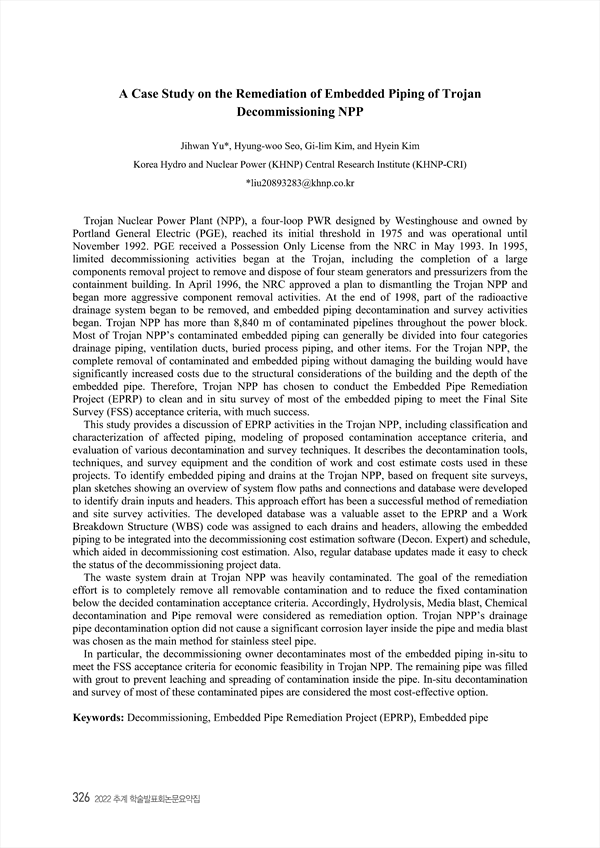

Trojan Nuclear Power Plant (NPP), a four-loop PWR designed by Westinghouse and owned by Portland General Electric (PGE), reached its initial threshold in 1975 and was operational until November 1992. PGE received a Possession Only License from the NRC in May 1993. In 1995, limited decommissioning activities began at the Trojan, including the completion of a large components removal project to remove and dispose of four steam generators and pressurizers from the containment building. In April 1996, the NRC approved a plan to dismantling the Trojan NPP and began more aggressive component removal activities. At the end of 1998, part of the radioactive drainage system began to be removed, and embedded piping decontamination and survey activities began. Trojan NPP has more than 8,840 m of contaminated pipelines throughout the power block. Most of Trojan NPP’s contaminated embedded piping can generally be divided into four categories drainage piping, ventilation ducts, buried process piping, and other items. For the Trojan NPP, the complete removal of contaminated and embedded piping without damaging the building would have significantly increased costs due to the structural considerations of the building and the depth of the embedded pipe. Therefore, Trojan NPP has chosen to conduct the Embedded Pipe Remediation Project (EPRP) to clean and in situ survey of most of the embedded piping to meet the Final Site Survey (FSS) acceptance criteria, with much success. This study provides a discussion of EPRP activities in the Trojan NPP, including classification and characterization of affected piping, modeling of proposed contamination acceptance criteria, and evaluation of various decontamination and survey techniques. It describes the decontamination tools, techniques, and survey equipment and the condition of work and cost estimate costs used in these projects. To identify embedded piping and drains at the Trojan NPP, based on frequent site surveys, plan sketches showing an overview of system flow paths and connections and database were developed to identify drain inputs and headers. This approach effort has been a successful method of remediation and site survey activities. The developed database was a valuable asset to the EPRP and a Work Breakdown Structure (WBS) code was assigned to each drains and headers, allowing the embedded piping to be integrated into the decommissioning cost estimation software (Decon. Expert) and schedule, which aided in decommissioning cost estimation. Also, regular database updates made it easy to check the status of the decommissioning project data. The waste system drain at Trojan NPP was heavily contaminated. The goal of the remediation effort is to completely remove all removable contamination and to reduce the fixed contamination below the decided contamination acceptance criteria. Accordingly, Hydrolysis, Media blast, Chemical decontamination and Pipe removal were considered as remediation option. Trojan NPP’s drainage pipe decontamination option did not cause a significant corrosion layer inside the pipe and media blast was chosen as the main method for stainless steel pipe. In particular, the decommissioning owner decontaminates most of the embedded piping in-situ to meet the FSS acceptance criteria for economic feasibility in Trojan NPP. The remaining pipe was filled with grout to prevent leaching and spreading of contamination inside the pipe. In-situ decontamination and survey of most of these contaminated pipes are considered the most cost-effective option.
